Glenview Avenue & Harwood Avenue
Alternatives may realign intersection to improve geometry and address sight-distance challenges and crash history.
The Wisconsin Department of Transportation (WisDOT), in partnership with the City of Wauwatosa, is studying improvements to Wisconsin Highway 181 (WIS 181) — also known as Glenview Avenue & Wauwatosa Avenue — between Wisconsin Avenue and Center Street. The goal is to extend the life of the roadway, update outdated infrastructure, and create a safer, more comfortable corridor for drivers, transit riders, pedestrians, and bicyclists.
Learn more on the WisDOT project webpage or the project newsletter.

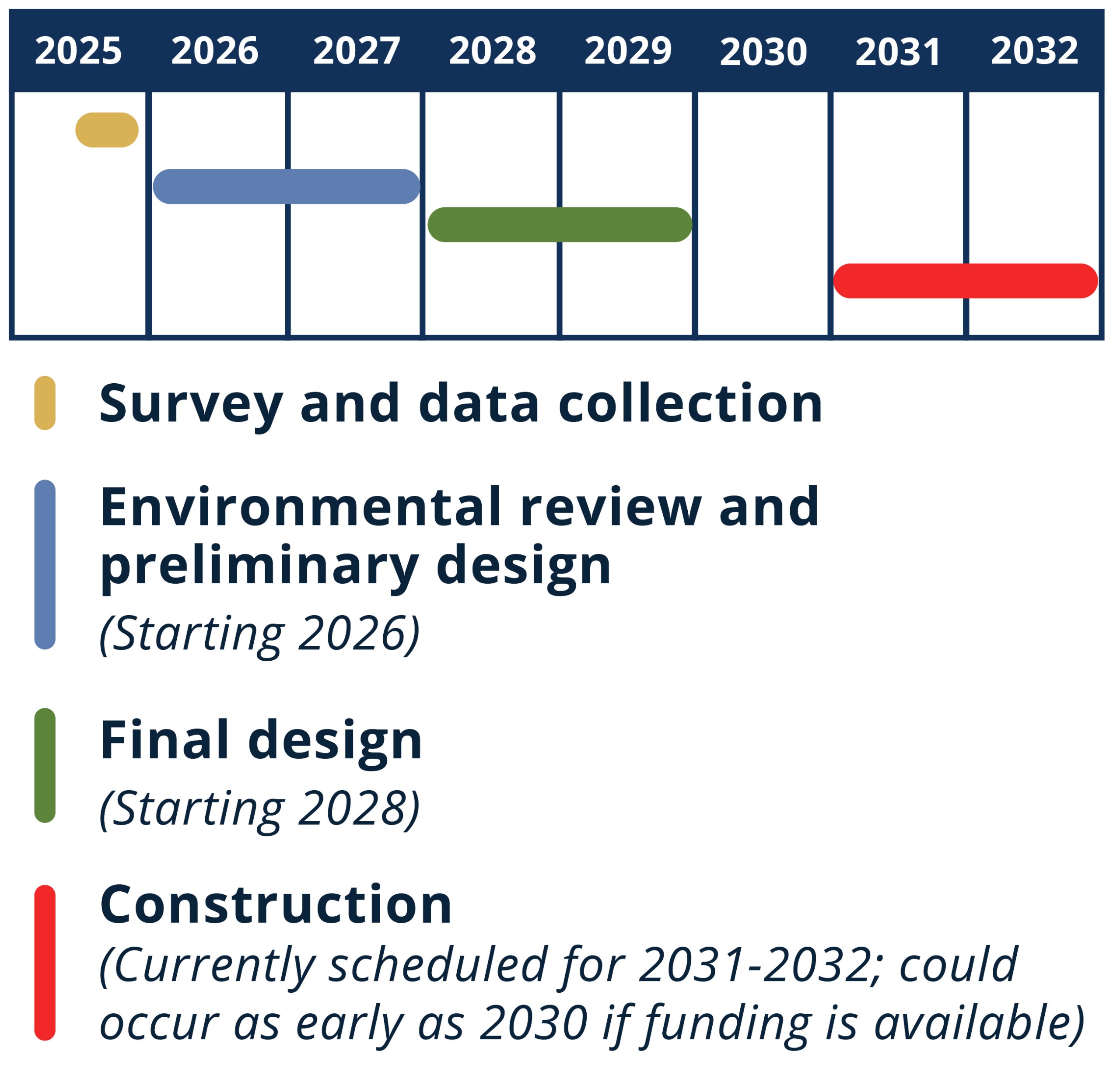

Five intersections along WIS 181 are being studied for possible layout changes. These improvements are focused on:
Alternatives may realign intersection to improve geometry and address sight-distance challenges and crash history.
Intersection with high traffic. Options may simplify layout and improve pedestrian safety.
Central Village hub intersection. Improvements could include crosswalk upgrades, curb extensions, modern signals, and lane reassignment to improve traffic flow.
Narrow intersection with turning and pedestrian conflicts. Updates may include lane reconfiguration and ADA ramp upgrades.
The corridor's busiest intersection. Alternatives are being developed to improve pedestrian and cyclist safety.
